Skip to content
MyQS Ltd · Estimating serviceSheet E60-001 · Rev A · 13 Oct 2026
8:00 - 18:00 Mon - Fri

Send your drawings.
Get a measured estimate back in 60 minutes.

Not a ballpark. Not a rate per square metre. A proper quantity take-off with every item measured off your drawings and priced line by line, labour and materials separated, with a programme and a proposal on your own letterhead.

No account. No subscription. One payment, one job.

60
Minutes
working hours
£149
Fixed fee
nothing else to pay
131
Lines
on the sample
3
Documents
all white-labelled

How it works

  1. 01

    Send the drawings

    Floor plans, elevations, sections, M&E layouts. PDF or photos of a printed set. Tell us in a sentence what you are pricing.

  2. 02

    Pay the fixed fee

    £149. Card, through Stripe. Nothing starts until the payment clears, and the clock starts at the same moment.

  3. 03

    Get it back in 60 minutes

    Estimate, bill of quantities and programme. On your letterhead, with your logo. Send it straight to your client.

Read a real one

A garage conversion and rear extension priced from the architect's pack. 131 measured lines, £138,203.64. The scheme is renamed and the client removed. Every quantity and every measurement note is exactly as we issued it.

Cover page of the sample proposal
Cover

Your logo, your details, the headline figure. Your client never sees ours.

Cost summary page of the sample proposal
Cost summary

Where the money sits, element by element, before anyone reads a single line.

The drawing page of the sample proposal
The drawing

Your own drawing with the measurement marked over it. Areas, runs, openings.

The bill page of the sample proposal
The bill

Every line measured, priced, and carrying the sheet it was taken from.

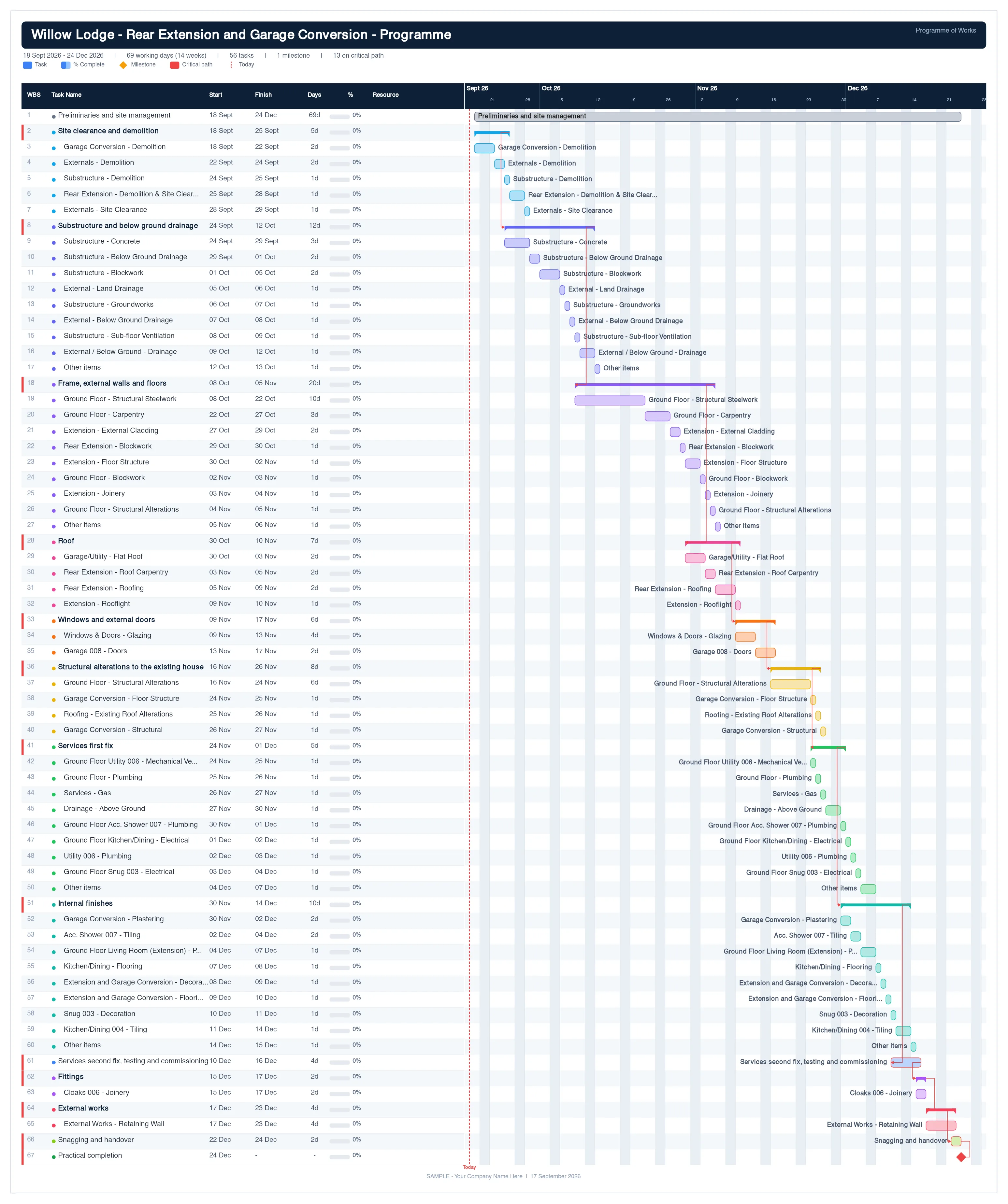

The programme: a Gantt chart sequenced from the priced works, showing each trade, its dates and the critical path
Programme

Sequenced from the priced works, with dependencies and the critical path. Included, not a £40 extra.

Scroll the programme sideways to read it

Click any page to download the full document. Samples are watermarked. Yours are not.

NOTE

Rates on the sample

Published in full for facilitating works, substructure, fittings, services, external works and preliminaries - £44,545.76 of the bill. Take a line, check the quantity against the drawing reference in its note, multiply by the rate. It will hold.

Withheld for superstructure, internal finishes and work to the existing building. Those lines still show scope, quantity and measurement basis, and the element totals are given, so the bill still adds up. The rate library is the part a competitor would copy. Your own estimate shows every rate.

Samples are watermarked. Yours are not.

Measured, not guessed

The take-off engine reads the drawing itself: areas, wall runs, openings, structural members. It confirms the scale from the printed bar rather than trusting the stated ratio, because reduced prints are common and assuming 1:50 on a sheet that printed at 1:52 puts every quantity out by four per cent.

SNUG 00313 m²KITCHEN/DINING 00426 m²LIVING ROOM 00516 m²HALL 00210 m²VESTIBULE0014 m²UTILITY0064 m²SHOWER0074 m²GAR.0083 m²12345674.30 mAREA, EXTENSION16.0 m²EXT. WALL RUN13.2 mWINDOWS, DOORS7 nrSTRUCT. OPENINGS3 nrGARAGE CONV. FLOOR12.0 m²STUD PARTITIONS42.5 m²SCALE CONFIRMED 1:50read from printed bar, not assumed04mNAreaLinearCountStructural
FIG. 1 - Illustrative plan. Your estimate is measured from your own drawings, and every line records the sheet and dimension it was taken from.

Traced to the sheet

Each line records the drawing and dimension it came from, so any number can be checked in seconds.

Labour and materials split

Every rate is broken down, so you can see what you are being told a job costs and why.

Checked by a person

Nothing is released automatically. A qualified estimator reviews the output before it reaches you.

It goes out as yours

You get a private panel for five days. Put your logo on it, set your company details, name your client, and every document rebuilds instantly with your branding. There is no MyQS mark anywhere on what your client receives.

Upload your logo

It sits on the cover and every page, the way your own letterhead would.

Your details, your client's details

Company name, address, registration, accreditations. Addressed to your client by name.

Your rates, if you want them

The panel has a rate sheet. Put in your own labour rates by trade and the whole estimate recalculates in front of you, live. Our quantities, your prices.

Five days to edit and download

Change anything, download as often as you like. After five days the details lock, but your documents stay available on the same link.

Your logo
Your Company Ltd
Your address
QUOTATION
Ref MQ-2026-0804
PREPARED FOR
Your client's name
DESCRIPTIONQTYAMOUNT
Excavate trenches, strip foundation5.04 m³£202
A252 mesh to foundations23.1 m²£289
Cavity wall below DPC11 m²£1,144
110mm uPVC drainage22 m£3,036

+ 160 further measured lines

No MyQS branding anywhere on it.

Fees

One payment per job. No subscription, no account, no credits. Every tier includes the estimate, the bill of quantities, the programme and the proposal.

Simple domestic
£149

Extensions, loft conversions, garage conversions.

Larger residential
£249

New builds and whole-house schemes.

Commercial & multi-unit
By quote

Send the drawings. We review them and quote a fee before you pay anything.

For comparison. A typical UK estimating service charges around £120 plus VAT for an extension, then £40 for a programme and £35 for the Excel bill on top, and takes three to five working days. That is roughly £195 net for the same four documents. Ours is £149 all in, and it is back inside the hour.

Questions

Sixty minutes is not long enough to price a job properly.

It is when the measuring is done by machine and the checking is done by a person. The hours that normally go into scaling off drawings are the hours we removed. A qualified estimator still reviews every line before it is released, and nothing goes out automatically.

How do I know the quantities are right?

Every line records the drawing and the dimension it came from. Take any line on the sample, find the reference in the note, check it, and the arithmetic will hold. We also read the scale off the printed bar rather than trusting the stated ratio, because reduced prints are common and a sheet that printed at 1:52 instead of 1:50 puts every quantity out by four per cent.

What if my drawings are not good enough?

If a set cannot be priced properly we tell you before we start, not after. In practice a planning set with dimensioned plans and elevations is enough.

Can I change the rates to my own?

Yes. Your panel has a rate sheet: put in your own labour rates by trade and the whole estimate recalculates in front of you. Your rates, our quantities.

Does my client see MyQS anywhere?

No. Every document carries your logo and your company details and nothing of ours. That is the point.

Do I need an account?

No. No signup, no subscription, no software to learn. You get a link to a panel that stays open for five days.

Start your estimate

Upload the drawings and tell us what you are pricing. The clock starts when your payment clears.

0/20 minimum. The more specific you are, the closer the estimate - this is the single biggest thing you control.

Drawings

Payment taken by Stripe. We never see your card details.

Estimates are prepared from the drawings you supply. We do not carry out a site visit, so existing conditions, ground conditions and buried services are not verified on site. Working hours 8:00 - 18:00 Monday to Friday, excluding public holidays. Purchases are non-refundable once work has begun.
